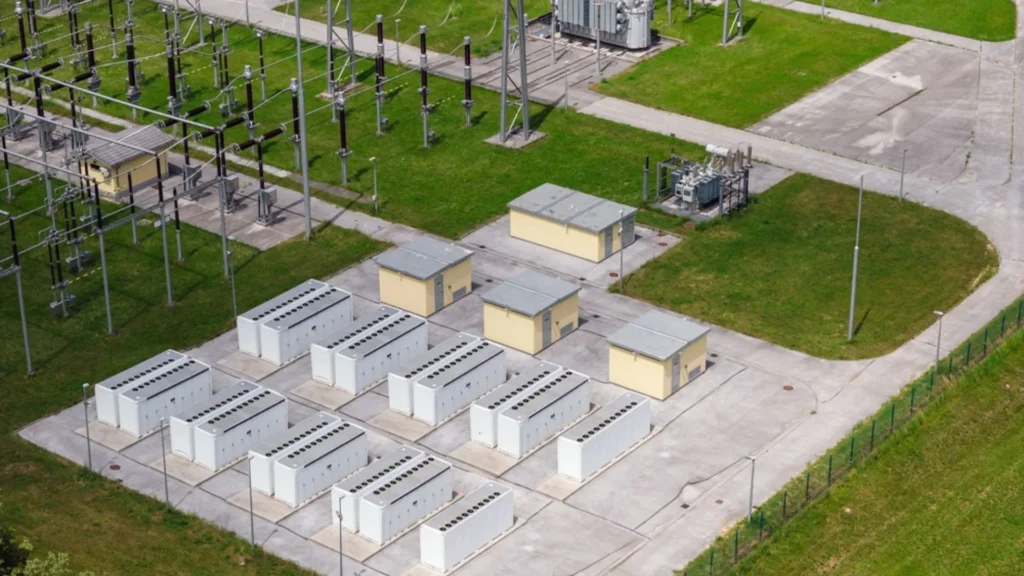

Econergy has secured financing agreements for approximately €229 million, equivalent to $265 million, to move forward with Părău 2. The energy project is being built in Brașov County, Romania, and will combine solar photovoltaic generation with battery storage.
In addition, Părău 2 will have a 342 MWp photovoltaic plant along with a 150 MW/300 MWh BESS energy storage system. The installation will allow some of the electricity produced to be stored and later delivered to the grid as needed.
The project is already under construction and Econergy expects to begin commercial operation in early 2028. Before then, the loan agreements must meet the corresponding conditions and financial closing is expected within a period of three months.
Specifically, the financing comes from a consortium made up of six financial entities, the operation involves Banca Comercială Intesa Sanpaolo România together with its subsidiary Privredna banka Zagreb, the Black Sea Trade and Development Bank, the European Bank for Reconstruction and Development (EBRD), Exim Banca Românească, NLB and OTP Bank.
In this way, Econergy obtains resources to develop a project that combines two technologies at the same site. On one hand, there will be photovoltaic generation, and on the other, energy storage using batteries.
The financing also shows the economic scale that Părău 2 has reached. Its 342 MWp of photovoltaic capacity will be accompanied by a BESS designed to store up to 300 MWh of energy.
The solar plant will have a peak power of 342 MWp. The BESS system will have 150 MW of power and 300 MWh of storage capacity.
This combination will allow a portion of the electricity produced by the solar project to be stored. This energy can then be supplied to the grid when needed.
Thus, energy storage will give greater flexibility to the operation of Părău 2. It will also facilitate the integration of renewable production within Romania's electricity system by reducing the dependence on generation and consumption coinciding at the same time.
In practical terms, the 150 MW power indicates the system's delivery capacity, while the 300 MWh represents the amount of energy it can store.
Therefore, the BESS can shift some of the electricity generated by the solar panels over time. This feature is important in a photovoltaic project due to the variations in generation throughout the day.
Furthermore, the joint installation of the plant and the batteries will allow for more flexible management of the electricity produced before supplying it to the grid.
Within the financial structure, the EBRD is considering a contribution of up to €120 million. This amount is divided into loan A of up to €57 million and loan B of up to €63 million.
In turn, loan B incorporates a debt service line of 3.6 million euros, provided by Privredna banka Zagreb and NLB.
On the other hand, Intesa Sanpaolo and Exim Banca Românească will jointly provide a €25 million line of credit earmarked for VAT. This will be supplemented by another €9.5 million line of credit related to Părău 2's participation in Romania's Contracts for Difference (CFD) mechanism.
In addition, approximately 114.4 million euros of the main line are backed by an InvestEU guarantee from the European Union.
This hedge is intended to reduce the risks associated with the project's exposure to revenue from the electricity market. This backstop is particularly important because a portion of Părău 2's capacity will be sold on the market.
Meanwhile, Părău 2 secured the largest capacity allocation in Romania's first contract for difference auction.
The project received an allocation of 125 MW of alternating current at an exercise price of €49.4 per MWh. The agreement will last for 15 years from the date the facility begins operating.
Meanwhile, the generation capacity that remains outside of that allocation will be exposed to electricity market prices.
The CfD provides a long-term revenue benchmark for the 125 MW included in the contract. This way, a portion of the production will have a mechanism in place for 15 years.
However, Părău 2 will also maintain market exposure. This combination explains the relevance of the InvestEU guarantee within the agreed financing structure for the project.
Părău 2 is currently under construction. According to the published schedule, Econergy expects the project to begin commercial operation in early 2028.
Before reaching that stage, financial closing must be completed. The loan agreements are subject to customary terms and conditions, and this process is expected to conclude in approximately three months.
Once operational, the complex will incorporate both photovoltaic generation and energy storage on the same site. This will allow Econergy to manage an asset that can produce electricity during daylight hours and store a portion for later delivery.
Finally, Părău 2 demonstrates how battery storage can be directly integrated into large-scale solar projects. The facility will not rely solely on its 342 MWp photovoltaic capacity, as it will also have 300 MWh of electricity storage capacity.
This configuration can bring greater flexibility to the Romanian electricity system as generation from renewable sources increases. The batteries allow for better management of the differences between solar production hours and the times when the grid needs electricity.
For Econergy, the €229 million financing provides the necessary resources to continue construction of one of its largest projects in Romania. The next step will be to complete the financial closing and move towards the planned start of operations in early 2028.
